How Long Does a Bathroom Remodel Take? 2026 Timeline

Completed bathroom remodel with walk-in shower and modern finishes Raleigh

What you need to know now about how long a bathroom remodel takes:

  • A standard professional renovation takes about 4 to 6 weeks from demolition to final walkthrough, though extensive layout modifications or plumbing relocations can easily stretch the schedule to 6 to 8 weeks.
  • Pre-ordering custom vanities, specialty tile, and imported fixtures 4 to 8 weeks before demolition is mandatory to prevent your project from grinding to a halt mid-construction while your home sits gutted.
  • Unexpected structural issues like hidden mold or water-damaged subfloors pop up in nearly 30% of older homes, automatically adding 3 to 5 days of remediation time to the production phase.
  • Keeping your layout identical cuts construction time down significantly, whereas moving major fixtures like toilets requires cutting concrete slabs and waiting on municipal inspections before any finishes can go down.

The National Association of Home Builders reports bathroom remodeling remained the most common home improvement project in 2025, with 73% of remodelers rating it as common to very common. That demand means skilled trades stay booked.

Your timeline depends on three things: project scope, permit requirements, and whether your contractor finds hidden problems during demolition.

What Determines How Long Your Bathroom Remodel Takes?

Project scope controls everything. A cosmetic refresh touches only what you see. A full gut strips the room to the studs and replaces every system.

The difference shows up fast. Swapping a vanity and painting walls takes days. Relocating the toilet drain requires cutting concrete, rerouting plumbing, and scheduling multiple inspections.

Permit approval adds 1 to 3 weeks before demolition starts in most North Carolina municipalities. Raleigh and surrounding municipalities require permits for any work involving plumbing, electrical, or structural changes.

We’ve seen projects delayed by weeks because homeowners ordered specialty tile without checking lead times or didn’t finalize fixture selections before demo day.

Read on to discover exactly how a premium builder coordinates every trade to keep your timeline tightly on track without sacrificing structural integrity or waterproofing.

How Long Does a Small Bathroom Remodel Take?

Small bathroom remodels take 2 to 4 weeks when the layout stays the same. You’re working in tight quarters, which slows tile work and fixture installation, but the reduced square footage balances that out.

A powder room refresh with new paint, fixtures, and lighting finishes in 5 to 7 days if materials arrive on schedule.

Replacing the vanity, toilet, and adding new floor tile pushes the timeline to 2 weeks. The tile needs setting time, grout needs curing time, and fixtures can’t install until tile work completes.

Layout changes eat time fast. Moving a toilet 3 feet means cutting the slab, relocating the drain, pressure testing the new line, and waiting for inspection approval before tile work begins.

Small spaces move fast when you keep the layout. See how BoCo Select’s pre-selected finishes eliminate decision delays. Explore BoCo Select Bathrooms →

How Long Does a Full Bathroom Renovation Take?

Full bathroom renovations take 3 to 6 weeks from demolition to final walkthrough in the Raleigh area. This covers gut remodels where everything comes out and gets rebuilt.

  • Week 1 to 2 focuses on demolition and rough-ins. Crews tear out existing fixtures in 1 to 2 days, then spend 3 to 5 days on plumbing and electrical rough-in work. Inspectors verify this work before walls close up.
  • Week 3 handles structural work. Drywall or backer board goes up in 1 to 2 days. Waterproofing takes another 1 to 2 days and requires drying time before tile work starts.
  • Week 4 is tile week. Wall and floor tile installation takes 3 to 5 days depending on pattern complexity and square footage. Intricate designs like herringbone or large-format marble require more precision and time.
  • Week 5-6 brings finishing work. Grouting takes 1 to 2 days, painting and trim take another 1 to 2 days, and fixture installation needs 2 to 3 days for the toilet, vanity, faucets, and shower fixtures.

Hidden problems extend timelines. Mold behind shower tile, water-damaged subfloors, or outdated wiring that doesn’t meet current code all require remediation before finish work continues.

Hidden water damage or code compliance issues appear in roughly 30% of bathroom remodels in homes over 20 years old.

Curious what your project timeline looks like? Get a detailed estimate based on your specific bathroom. Use Our Free Calculator →

What’s the Typical Week-By-Week Bathroom Remodel Timeline?

Professional contractor reviewing bathroom remodel plans and timeline with homeowner

Week 1 to 2: Demolition and Rough-In Work

Day 1-2 is demolition. Everything comes out: fixtures, tile, vanity, sometimes drywall down to the studs. This phase reveals what’s hiding behind walls.

Day 3-12 covers rough plumbing and electrical. New valve installations, drain relocations, electrical circuits for outlets and lighting, and ventilation fan wiring all happen now.

Rough inspections occur during the second week. Building officials verify work is up to code before allowing walls to close and BoCo Modern performs Quality Control inspections.

Week 3: Waterproofing and Prep Work

Moisture-resistant drywall or cement backer board goes up in the first 1 to 2 days. Shower areas get cement board rated for wet environments.

Waterproofing takes 1 to 2 days including application and drying time. The waterproof membrane creates a barrier between moisture and your wall structure.

Some contractors start tile layout during this phase. Measuring, planning the pattern, and cutting edge pieces before setting any tile speeds up the actual installation.

Week 4: Tile Installation

Floor tile goes down first in most installations. The floor needs 24 to 48 hours of setting time before heavy foot traffic or wall tile work begins.

Wall tile follows. A standard tub surround takes 2 to 3 days. Full-wall tile in a walk-in shower adds another 1 to 2 days depending on size and pattern.

Custom tile work requires extra time. Detailed patterns, multiple tile sizes, or specialty materials like natural stone need careful placement and may extend this phase by several days.

Week 5 to 6: Fixtures and Final Touches

Grouting happens first. The grout needs to cure for 24 hours before caulking or cleaning.

Painting occurs after tile work finishes and grout cures. Ceilings first, then non-tiled walls and trim.

Fixture installation comes last. Toilet, vanity, sink, faucets, shower fixtures, mirrors, lighting, and hardware all install during the final 2 to 3 days.

Final inspection closes out the permit. The inspector verifies all plumbing connections hold pressure, electrical work meets code, and ventilation operates correctly.

Planning a walk-in shower? Learn what affects your project timeline and budget. Read Walk-In Shower Remodel Cost →

What Delays a Bathroom Remodel Timeline?

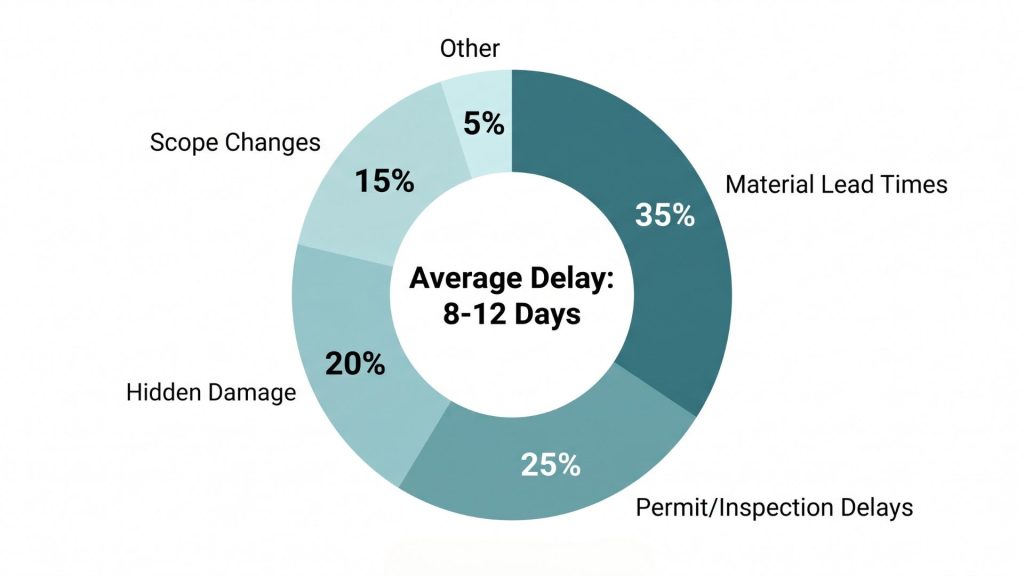

 Chart showing top causes of bathroom remodel delays and timeline extensions

Material availability causes the longest delays in 2026. Custom vanities, imported tile, and specialty fixtures often carry 4 to 8 week lead times from order to delivery.

Order materials early. Place orders 4 to 6 weeks before your scheduled start date, especially for custom items. Waiting until demo day to order a vanity adds weeks to your timeline.

Permit delays happen when applications lack required details or inspection scheduling runs behind. Submit complete applications with accurate plans, dimensions, and specifications to avoid review delays.

Hidden damage extends timelines unpredictably. Mold remediation, structural repairs, or plumbing that needs replacement all require extra time. Budget 3 to 5 additional days for unexpected issues in homes built before 2000.

Scope changes during construction cause major disruptions. Changing tile selections after demolition means ordering new materials and waiting for delivery while your bathroom sits gutted.

Inspection scheduling depends on municipal availability, not contractor preference. Plan for 2 to 6 days between calling for an inspection and getting an inspector on site.

Design decisions slow down projects. BoCo Select eliminates decision fatigue with pre-curated packages. See BoCo Select Options →

How Long Does Each Phase of a Bathroom Remodel Take?

PhaseDurationKey ActivitiesInspection Required
Demolition1-2 daysRemove fixtures, tile, vanity, flooringNo
Rough Plumbing2-3 daysInstall new valves, relocate drains, pressure testYes
Rough Electrical1-2 daysRun new circuits, install boxes, rough fan wiringYes
Drywall/Backer Board1-2 daysInstall moisture-resistant materials, tape, mudNo
Waterproofing1-2 daysApply membrane, allow drying timeSometimes
Floor Tile2-3 daysSet tile, allow curing timeNo
Wall Tile2-4 daysSet tile, custom patterns add timeNo
Grouting1-2 daysApply grout, clean, cure 24-48 hoursNo
Painting1-2 daysCeiling, walls, trimNo
Fixture Installation2-3 daysVanity, toilet, shower fixtures, accessoriesNo
Final InspectionHalf dayTest all systems, verify code complianceYes

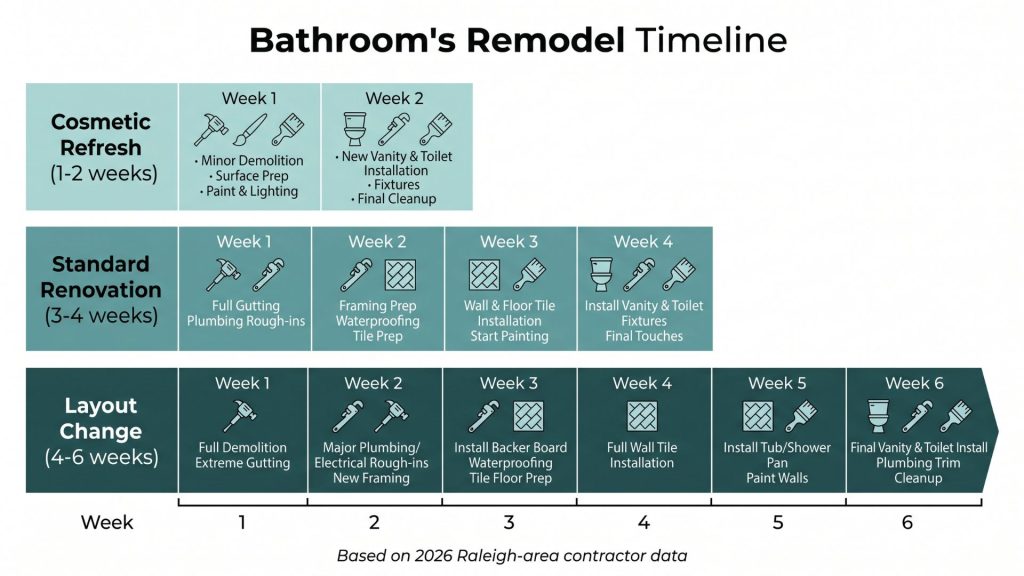

How Do Bathroom Remodel Timelines Compare by Project Type?

Project TypeTimelineTypical ScopePermit Required
Cosmetic Refresh1-2 weeksPaint, fixtures, lighting, hardwareUsually No
Standard Renovation4-6 weeksNew tile, vanity, fixtures, same layoutYes
Layout Change6-8 weeksRelocate fixtures, modify plumbingYes
Master Suite Addition6-10 weeksAdd space, multiple fixtures, custom tileYes
Accessibility Conversion3-5 weeksWalk-in shower, grab bars, wider doorYes

Can You Speed Up a Bathroom Remodel Timeline?

Order materials early. Custom vanities, specialty tile, and imported fixtures need 4 to 8 weeks from order to delivery in 2026.

Finalizing all design decisions before demolition keeps the project moving. Tile patterns, fixture finishes, paint colors, and hardware selections should lock in during the planning phase.

Experienced contractors who know local inspection requirements prevent permit delays. They submit complete applications, understand code compliance, and pass inspections on the first attempt.

Every mid-project change adds time. New tile selection? That means ordering, waiting for delivery, and adjusting the schedule. Changes cascade.

Your bathroom is completely unusable from demolition through final fixture installation. Plan alternatives before work begins.

What Should You Know Before Starting Your Bathroom Remodel?

Set realistic expectations. The 4 to 6 week timeline assumes materials arrive on schedule, inspections happen promptly, and no hidden damage appears.

Total project duration includes more than construction time. Add 2 to 4 weeks for design decisions, material ordering, and permit approval before demolition day.

Quality work takes time. Rushing tile installation or grouting to hit an artificial deadline compromises waterproofing and long-term durability.

Bathroom remodels remain the most common home improvement project according to National Association of Home Builders data from early 2026. That demand keeps skilled trade scheduling tight in most markets.

Get expert guidance on your timeline. Our team walks you through realistic scheduling for your specific project. Explore Bathroom Remodeling Services →

How Does BoCo Modern Handle Bathroom Remodel Timelines?

Modern bathroom renovation timeline from demolition to completion in Raleigh NC

We provide detailed week-by-week schedules during your initial consultation. You know what’s happening when, which trades are on site, and when inspections occur.

Materials get ordered 4 to 6 weeks before your start date. Early ordering prevents the delivery delays that extend most projects.

We handle all permit applications and inspection scheduling. Complete applications submitted with accurate plans prevent the review delays that add weeks to other projects.

Clear communication happens throughout. When something unexpected appears during demolition, we stop, show you the problem, explain the options, and get your approval before proceeding.

Tile choices matter for more than aesthetics. Pattern complexity directly affects installation time. See Bathroom Tile Ideas for Raleigh →

How Long Does a Bathroom Remodel Take? FaQ

Can I use my home’s main water line during a bathroom remodel?

Your main water line will only be shut off for a few hours on specific days when old valves are cut out and new rough plumbing is tied into the system. I always tell my clients that the rest of the house remains fully functional, so you can cook, use other bathrooms, and run appliances normally while construction is active in the space.

How does discovering asbestos behind old bathroom tile impact the schedule?

Finding asbestos immediately halts construction because standard crews cannot safely disturb it. You will need to hire a licensed abatement specialist to contain and remove the material, a process that typically adds seven to ten business days to the front end of your project before structural work can safely resume.

Does installing an electric heated floor system add significant time to the timeline?

Laying electric heating mats or hydronic tubes typically adds only a single day to the schedule. The real impact is the extra twenty-four hours of drying time required for the self-leveling mortar to fully cure before the tile installers can start laying down the actual flooring.

How does a winter remodel affect the overall construction schedule?

Cold weather rarely slows down internal construction, but it can affect the delivery of heavy materials and the mixing of certain outdoor-stored compounds. If overnight temperatures drop significantly, your builder must ensure the home interior stays consistently warm so drywall mud, thinset, and waterproofing membranes dry within their standard window.

Can you remodel two bathrooms simultaneously to save time?

Staggering the projects by a few days is usually faster because it allows specialized subcontractors like plumbers and tile setters to move fluidly from one room to the next without leaving the job site. However, I only recommend this if you have a third fully functional bathroom or can live elsewhere, as the noise, dust, and multi-room utility shut-offs make the home incredibly difficult to live in.

Your Bathroom Remodel Starts With a Realistic Timeline

Understanding the real timeline for your bathroom remodel helps you plan around work schedules, coordinate household routines, and set expectations with everyone using that bathroom.

The 4 to 6 week estimate applies to standard renovations with professional crews, complete material availability, and no surprises behind the walls.

Your specific timeline depends on project scope, material lead times, permit requirements, and what crews find during demolition.

Ready to start planning? Schedule a consultation to get a detailed timeline for your specific bathroom project. Contact BoCo Modern →
